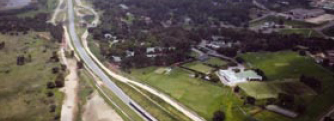

|
||||||||||||||||||||
|
||||||||||||||||||||
|
||||||||||||||||||||
|
||||||||||||||||||||
Major projectsMajor Project Update GAUTRAIN The Gautrain Rapid Rail Link project is
due to start full system trial operations
on the section between Sandton Station
and the OR Tambo International Airport
in March, with completion of a 10-week The contractual completion date for this first phase of the project is end June but Bombela, of which Murray & Roberts is a lead partner, and the client, the Gauteng provincial government, are negotiating an earlier completion date in time for the 2010 Soccer World Cup.

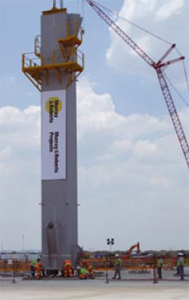

project milestones for 2010 Key project milestones for phase 1 include completion of all the electrical and mechanical (E&M) installation work in January, with the exception of some automatic fare collection equipment, and complete area integration testing in February. Completion of the main bus depot, which will feed into the train route is expected in February. Commencement of the trial running for phase 1 is due in March, with completion due early in June. OR Tambo International Airport, and Rhodesfield, Marlboro and Sandton stations should all be largely completed and operational before the end of May. Phase 2 milestones Key project milestones for phase 2 in 2010 include the completion of viaduct 5 construction through Centurion and handing over of Hatfield Station by the civil contractor to the E&M installation contractor. Testing and commissioning of the Midrand section, testing and commissioning of systems for the Centurion section, trackwork installation and power supply and distribution are also due for completion in 2010.
Most of the physical construction and installation work, as well as the bulk of the testing and commissioning on the Gautrain should be completed by the end of 2010. Handover and access to stations for E&M installation is expected to take place at the Pretoria, Rosebank, Centurion and Park stations between February and June 2010. Rolling Stock
The last sub-assembly for the rolling stock cars delivered from Derby to the UCW partnership in Nigel is expected to be completed by February, while the last rolling stock 4-car unit is expected to be completed for final acceptance testing by June.
GREEN POINT STADIUM The keys to the new Green Point Stadium were handed over to the Cape Town’s Executive Mayor, Alderman Dan Plato, on 14 December 2009. Construction of the 68 000-capacity stadium for the 2010 Soccer World Cup commenced in March 2007 and in just 33 months was completed, ahead of schedule, by Murray & Roberts and its partner. The stadium will host five first round World Cup matches, one second round match, one quarter-final and one semi-final. Enclosed by a façade of woven fiberglass coated with Teflon, the stadium resembles a rose-coloured bowl floating on a base when lit up at night. Capetonians have dubbed it “the Diva of Cape Town” as it reflects the constantly changing moods of the city in different weather conditions. More than 2 800 workers were employed on site during construction and almost 1 200 artisans received training from the contractors. A consortium comprising the South African Sail Group and the French-based Stade de France was awarded the service contract to operate the stadium and ensure that it remains a sustainable multipurpose venue after the 2010 World Cup.
|
||||||||||||||||||||
